Design and Build Foundations (@db_foundations) 's Twitter Profile
Design and Build Foundations

@db_foundations

At Design & Build we specialize in piled raft foundations, offering foundation solutions for both commercial and domestic projects.

ID: 1663926602764353538

linkhttp://dbfoundations.co.uk calendar_today31-05-2023 15:14:06

12 Tweet

46 Followers

79 Following

Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

Take a look at one of our recently completed projects. It is a non-voided piled raft slab with multiple steps as shown in this picture. A luxury house is currently being built on top.

Take a look at one of our recently completed projects. It is a non-voided piled raft slab with multiple steps as shown in this picture. A luxury house is currently being built on top.
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

This is one of our completed projects in central London. It is a residential building containing 12 units. The aim of the project was to transform an old car park into affordable living for the residents of the Newham. We worked on this job alongside Bonds Builders Ltd.

This is one of our completed projects in central London. It is a residential building containing 12 units. The aim of the project was to transform an old car park into affordable living for the residents of the Newham. We worked on this job alongside <a href="/bondsbuilders/">Bonds Builders Ltd</a>.
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

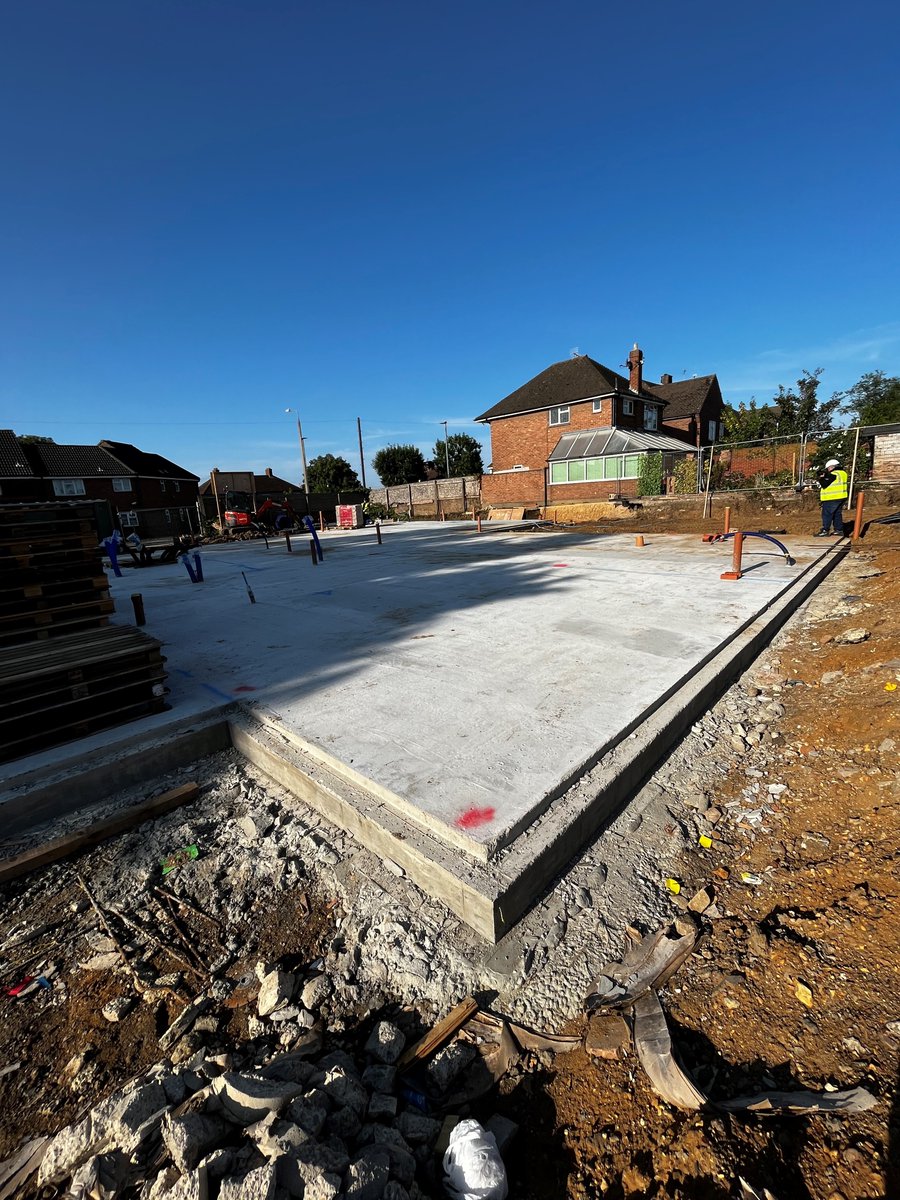

Here's another one of our completed projects in Essex. It is another non-voided piled raft slab. These photos were taken just 7 days apart, showing how efficient our work can be! A block of 3 story flats will now be constructed on our foundation.

Here's another one of our completed projects in Essex. It is another non-voided piled raft slab. These photos were taken just 7 days apart, showing how efficient our work can be! A block of 3 story flats will now be constructed on our foundation.
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

Another job CompletešŸ‘! Here's a few photos from our recently finished jobs in Chichester, showing our ground beams. #Construction

Another job CompletešŸ‘! Here's a few photos from our recently finished jobs in Chichester, showing our ground beams.
#Construction
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

Job well done šŸ‘. This is another one of our recently completed jobs. It is a 498 square meter piled raft slab. The slab is 250mm thick and non-voided. As there was no plasticity in the ground, there was no need for heave protection. 91nr 300mm CFA piles support our foundation.

Job well done šŸ‘. This is another one of our recently completed jobs. It is a 498 square meter piled raft slab. The slab is 250mm thick and non-voided. As there was no plasticity in the ground, there was no need for heave protection. 91nr 300mm CFA piles support our foundation.
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

Hello everyone. Our lad Josh is running a half marathon i the summer and is raising money for the sense charity. Have a look on the link to read more about the charity and make a donation. Thank you! #charity #sense #marathon

Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

Here's another finished slab, marking the result of our work. We installed 26 piles to support the 110-square-meter foundation, as planned in the concept. Ultimately, this project will provide two additional dwellings, contributing to housing in South London. #Constitution

Here's another finished slab, marking the result of our work. We installed 26 piles to support the 110-square-meter foundation, as planned in the concept. Ultimately, this project will provide two additional dwellings, contributing to housing in South London.

#Constitution
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

As the common saying goes, another year another CHAS certificate! We are happy to share with you all that we have recently been certified as a CHAS Advanced member for another year, showing our commitment to health & safety and our staff's welfare.

As the common saying goes, another year another CHAS certificate!

We are happy to share with you all that we have recently been certified as a CHAS Advanced member for another year, showing our commitment to health &amp; safety and our staff's welfare.
Design and Build Foundations (@db_foundations) 's Twitter Profile Photo

Here’s another one of our recently finished slabs. We worked alongside Perfect Home to provide foundation to support a new Sixth Form block. We installed 65nr 300mm cfa piles to an average depth of 8m. We then constructed 225mm R/C slab that spanned 550 square meters.

Here’s another one of our recently finished slabs. We worked alongside Perfect Home to provide foundation to support a new Sixth Form block.
We installed 65nr 300mm cfa piles to an average depth of 8m. We then constructed 225mm R/C slab that spanned 550 square meters.
