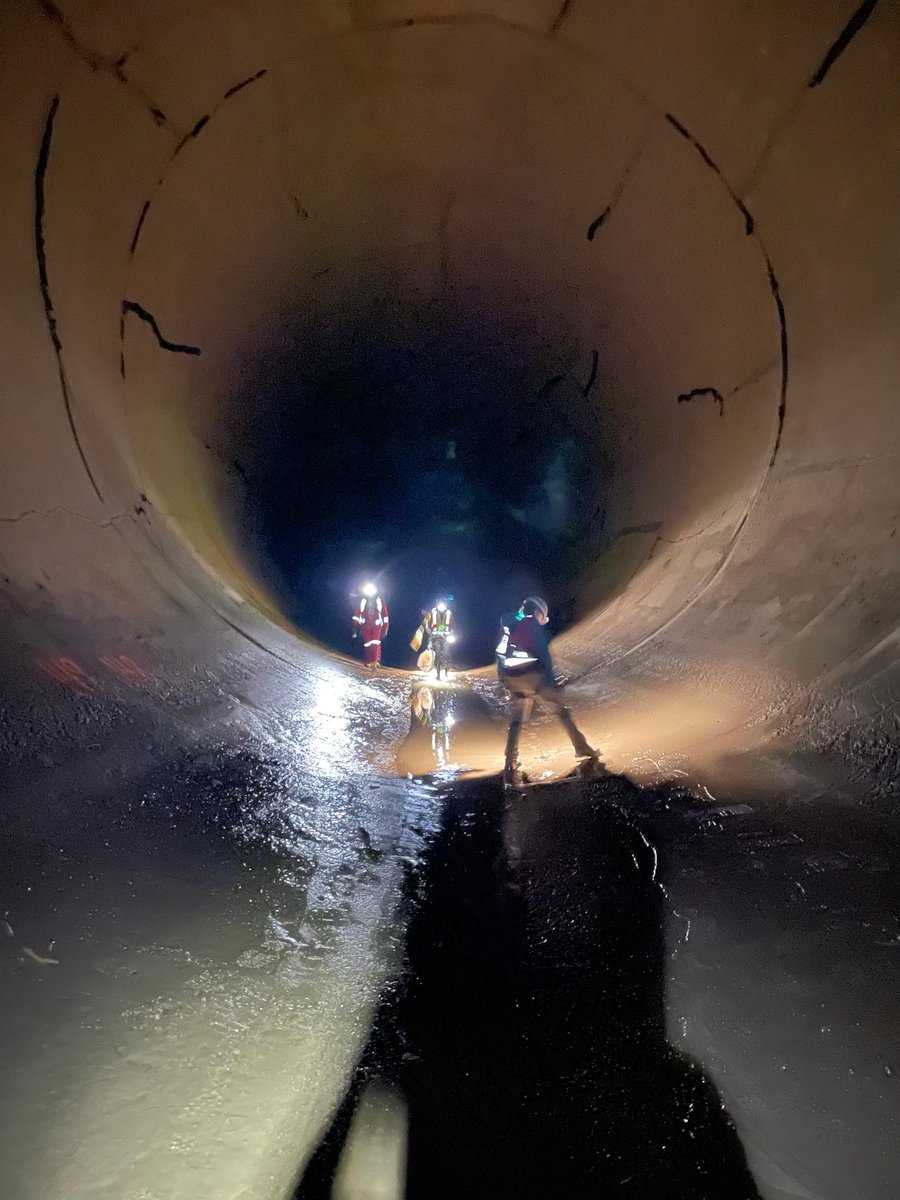

We’ve begun the process of converting (closing) one of the diversion tunnels to prepare for #SiteC reservoir filling, which could start as early as this fall. Tunnel conversion takes about 12 weeks to complete.
Learn more: ow.ly/Sxxm50OYs0V

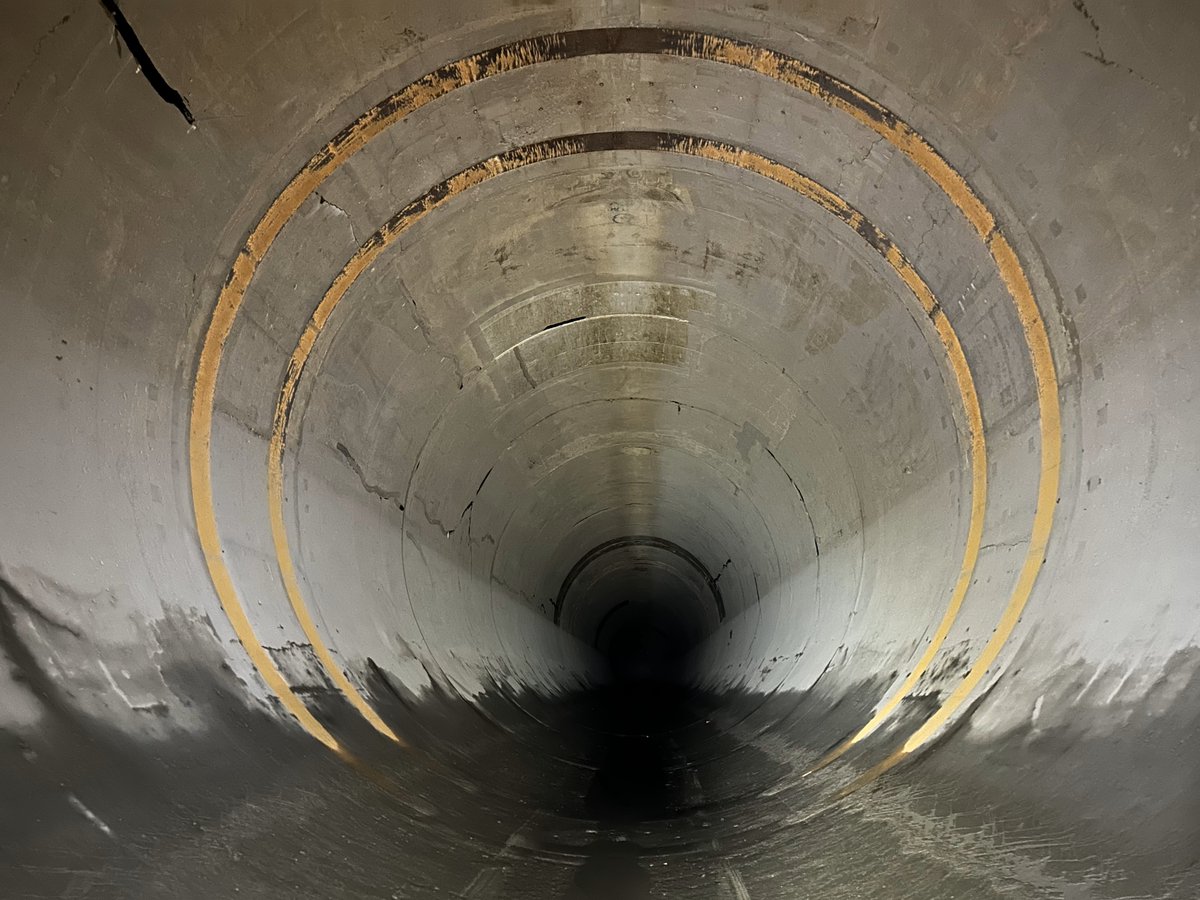

Four large rings are being installed inside one of #SiteC's diversion tunnels. This is an important step to prepare for reservoir filling as early as this fall.
Learn more in our construction bulletin: ow.ly/fXRl50P1PEg

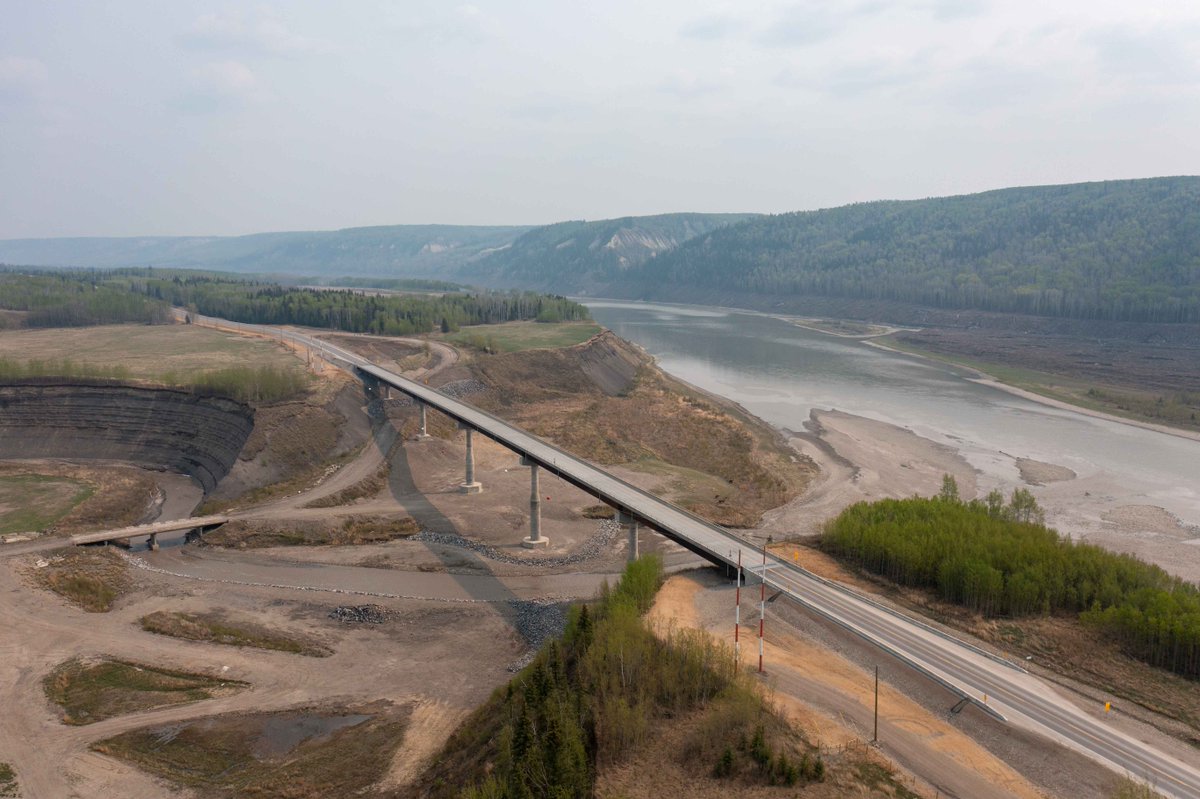

MILESTONE: The realignment of Highway 29 between Fort St. John and Hudson’s Hope is complete.
Working with the Ministry of Transportation and Infrastructure, we’ve built about 30 km of highway to prepare to fill the #SiteC reservoir as early as this fall. ow.ly/VIAV50P3yfH

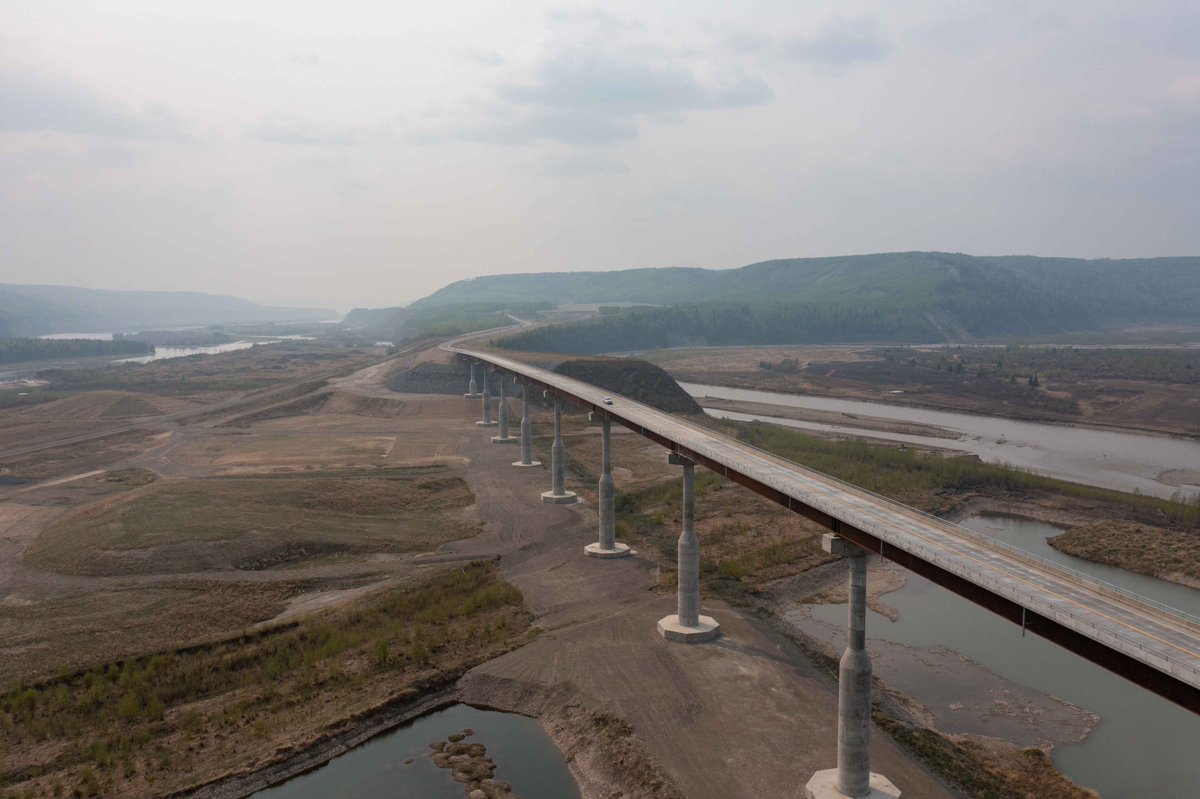

Approximately 30 km of highway were realigned, improving safety and travel times along the corridor. Watch this video to see all five new bridges: youtube.com/watch?v=yxiMy9…

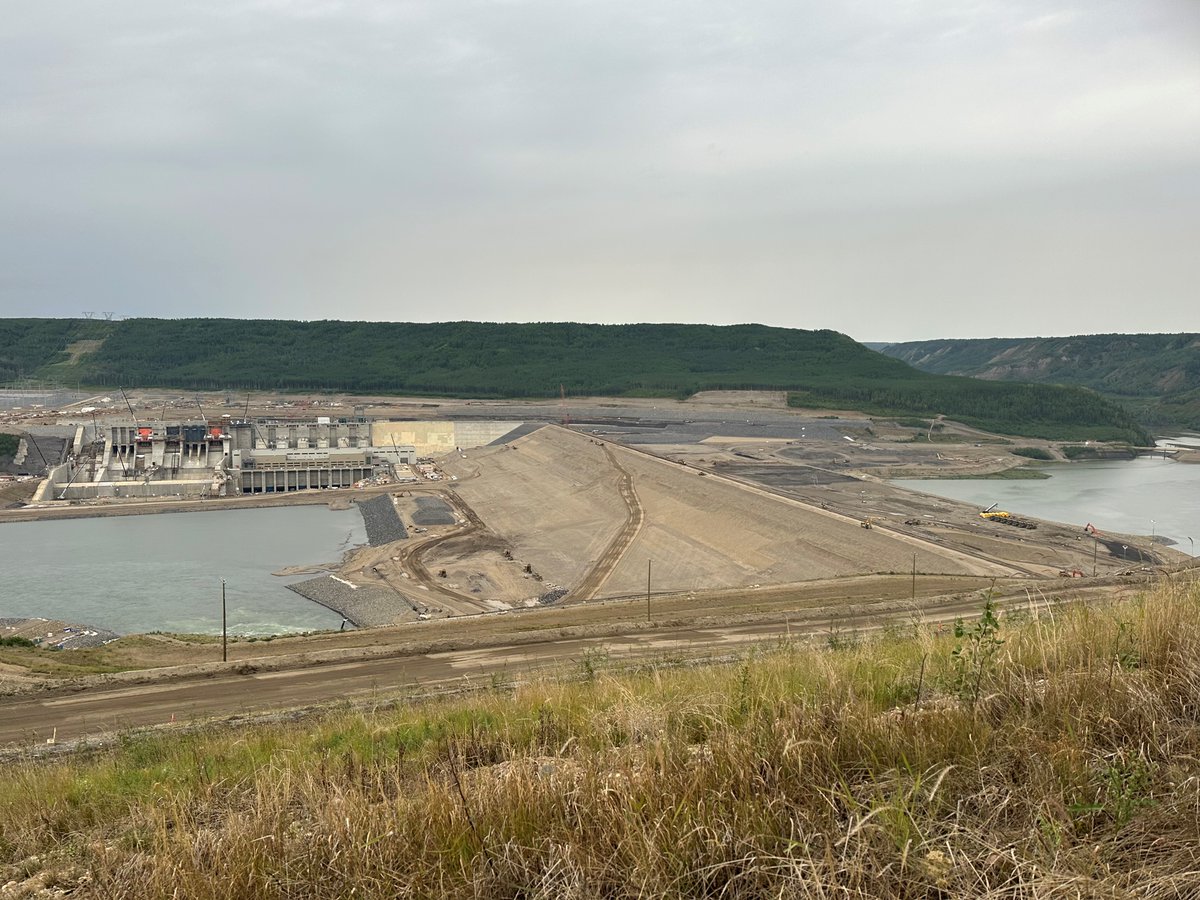

We have finished building the #SiteC earthfill dam. Completing the dam is one of the essential milestones required before filling the reservoir. We continue to target starting reservoir filling this fall. Read the announcement: sitecproject.com/earthfill-dam-… (1 of 3)
As we prepare to fill the #SiteC reservoir, we're strongly encouraging boaters to stay off the water during filling and for at least one year after.
Check out our video to learn more about boater safety: ow.ly/F02350PH1ux

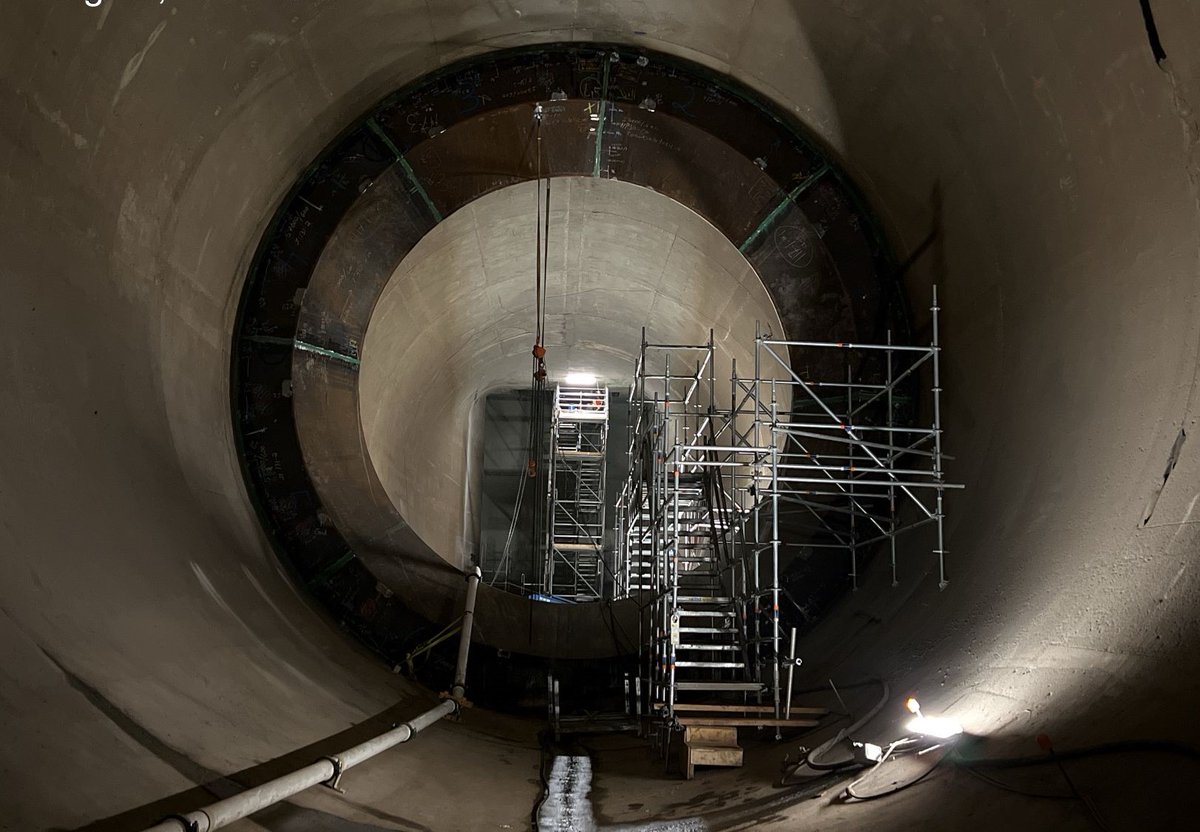

MILESTONE: #SiteC tunnel conversion is complete. We installed four large rings inside one of the two tunnels diverting the Peace River. These rings will play a key role in reservoir filling, which could start as early as this fall. ow.ly/YX5J50PKTRo
We’ll monitor the slopes around the #SiteC reservoir during and after reservoir filling to ensure it is safe for the public.
Watch our latest video to learn more: ow.ly/mgVb50PNxAR
We've worked with First Nations to incorporate Indigenous place names along Highway 29 by the future Site C reservoir. Dual-language signs in Dane-zaa Záágéʔ recognize the deep Indigenous culture and history in the area: ow.ly/IhuG50PQUMr #TruthAndReconciliationDay
We recently installed one of three transmission towers on top of the #SiteC dam intakes.
A total of 11 towers and three new transmission lines will send electricity generated inside the powerhouse to the nearby substation.
Learn more: ow.ly/n1zh50QkMuj
A huge thanks to our staff for working hard to clear snow at schools sites so they are accessible to welcome students & staff to school today! We're grateful to all essential staff members who worked hard these last several days! Please allow extra time to get to and from school.
All public boat launches on the Peace River between Hudson's Hope and Fort St. John are now closed.
We're preparing to start filling the #SiteC reservoir in the last week of August. New boat launches will open at least one year after filling is complete.
We've energized the first of three transmission lines connecting #SiteC's generating station with the newly built substation. This is an important step toward achieving first power later this year.
Watch to see how we used a drone to string these lines: ow.ly/ZsOA50T3rml
We have begun safely filling the #SiteC reservoir.
For up to four months, water levels will rise between 30 centimetres and three metres a day. The public is strongly urged to stay out of the reservoir area during filling and for at least one year after.
ow.ly/YJJ950T63l3
This morning, water from the #SiteC reservoir began flowing into the approach channel and over the spillway. The spillway ensures water safely passes downstream as reservoir filling continues.
Learn more about reservoir filling: sitecproject.com/reservoir
The second generating unit on the Site C project has come into operation and is providing power into BC Hydro’s electricity system.
Learn more: ow.ly/97Ne50UsNlg
Hon. Adrian Dix, Minister of Energy and Climate Solutions, recently visited Site C to get a firsthand look at construction progress.
Two generating units are in operation, providing power to BC Hydro customers. The third unit is expected to come into service soon.
We've reached a historic milestone with the successful commissioning of the sixth and final generating unit.
With all six units in service, Site C has the capacity to generate enough electricity to reliably power about 500,000 homes annually.
Learn more: ow.ly/5JE250WCpVi
